Wallowa Lake Dam construction delayed by a year
Published 11:00 am Sunday, October 30, 2022
- Funding and design progress on the century-old Wallowa Lake Dam are underway in 2022, but the start date on construction has been pushed back a year to the fall of 2024.
WALLOWA LAKE — Funding delays and rising costs are pushing back the construction start date for the refurbished Wallowa Lake Dam by a year, but design and funding progress are underway, according to Dan Butterfield, president of the Wallowa Lake Irrigation District.
Butterfield said Thursday, Oct. 27, that the groundbreaking on the dam is expected to take place in fall 2024, after irrigation season concludes.
The district, which owns the dam, is but one of the major stakeholders of the project. Others include the Oregon Department of Fish and Wildlife, the Nez Perce Tribe’s Department of Fisheries Resources Management and the Confederated Tribes of the Umatilla Indian Reservation. Minor stakeholders also are involved, among them the U.S. Fish and Wildlife Service, which has jurisdiction over bull trout, the National Oceanic and Atmospheric Administration and the Oregon Department of Environmental Quality.
Funding
Butterfield said funding is coming in. The stakeholders now have access to $14 million from the sale of state lottery bonds. They’ve also received $750,000 from ODFW for design and engineering work on the dam and another $500,000 from ODFW for design of the consolidated diversion of the Wallowa River.
Butterfield said that diversion will take out four irrigation ditches from the river.
“They need to be rebuilt and screened so fish can’t get into ditch systems anymore,” he said.
Butterfield said that portion of the project is expected to cost $5-$6 million.
In fact, the cost of the entire project has skyrocketed due to inflation and the increased cost of construction materials. What was originally estimated to be a $16 million project is now projected at least $21 million, he said.
He added that numerous grants have been written to help with the shortfall, and word is expected in December on whether those grants came through and how much they will be.
“We’re confident on grants that’ve been written, and they’ll help us cross the finish line,” he said. “We have to stay positive.”
But as inflation keeps driving up costs, the stakeholders are even more eager to begin construction.
“We have to go,” Butterfield said. “We have to get started.”
Fish passage
One of the issues that it took the stakeholders time to agree upon was the type of fish passage to be included in the dam. State law requires including such a passage, and the two major types considered were a fish ladder and a “trap and haul” system.
The stakeholders were leaving it up to the engineering firm for the dam to decide on the type of fish passage to include. McMillen Jacobs and Associates, of Boise, with Wallowa County native Mort McMillen at the helm, determined a fish ladder would not work well at the dam.
Butterfield said the consensus among the stakeholders leaned toward the trap and haul system, but they’re “still working out the details that will work for everyone.”
He said that the constant rise and fall of the lake level and the freezing in the winter make a fish ladder impractical. That’s not to mention the cost.
“It would take more concrete to do fa ish ladder than it would to do the dam,” he said. “It’s not part of the conversation anymore.”
The trap and haul system involves creating a catch basin at the base of the dam that will attract the fish. From there, the fish are collected, placed in a water-filled truck and hauled to wherever in the lake it is determined they should be unloaded.
“It sounds simple but it’s kind of complicated,” Butterfield said. “We’re working out the details.”

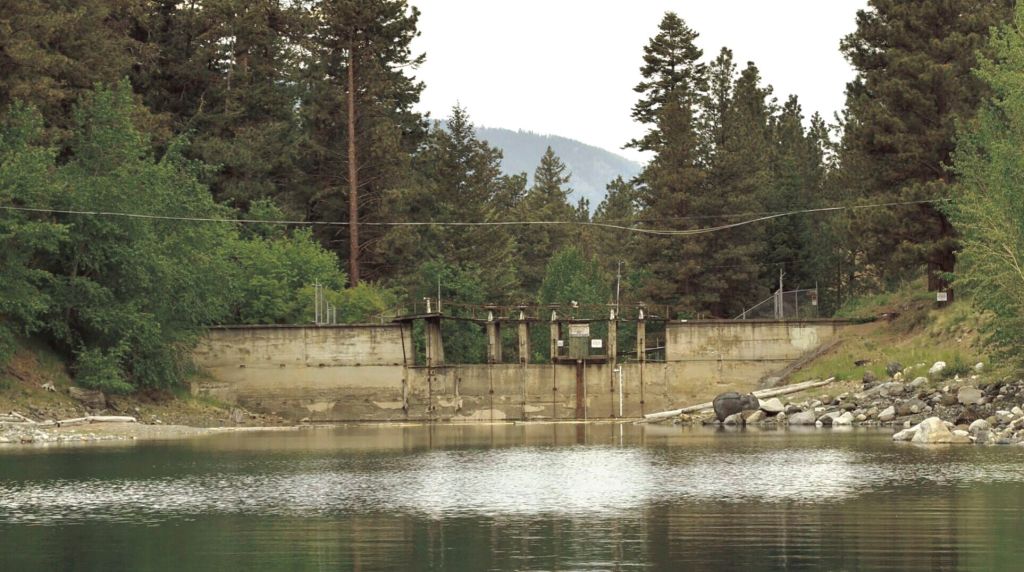

The dam
Refurbishing the century-old dam has been a desire of the stakeholders for nearly 25 years, Butterfield said. The plans include improving the spillways, installing the fish passage, adding more concrete for weight, replacing the five conduit gates with new ones and upgrading the electrical and instrumentation.
Right now, the dam keeps adequate water in the lake to irrigate the Wallowa Valley. Butterfield said Oct. 27 the lake level was at 9.5 feet, or about 45% of capacity. He said the dam can allow the lake to fill to about 20.8 feet.
Once the dam is refurbished, he said, it will allow for another 8 feet.
Indeed, there’s light at the end of the tunnel now.
“We feel pretty good about where we’re going, and it’s good to have this project started finally,” Butterfield said. “Persistence is going to pay off.”
